The McElhanney Study is a political document masquerading as a technical one

“It is interesting how TransLink has used this cunning method of manipulating analysis to justify SkyTrain in corridor after corridor, and has thus succeeded in keeping its proprietary rail system expanding.”

Gerald Fox, 2008

Malcolm Johnston, 2019


Please deliver to Mayor and Council.

My name is Malcolm Johnston and I have been involved in Metro Vancouver transit issues since 1986 and I again involving myself with the proposed Broadway subway, which is being supported by a foundation of deceit and deception which sadly, seems the common story today in BC.

I find it odd that what we call SkyTrain, has been rejected around the world as being hugely expensive to build than light rail and also has been found to cost more to operate and maintain.

Bombardier Inc. the sole vehicle supplier of the proprietary railway has now folded the Innovia Metro (Mk. 2 & 3 vehicles) line into the existing Movia Metro Line of vehicles. Bombardier likes it so much that ART SkyTrain isn’t even identified as a separate product anymore. It been buried into the larger, better selling Movia line. This means every bit of technology on the SkyTrain is now a design option and not connected permanently to the product. As far as Bombardier is concerned, the SkyTrain has now become indistinguishable from its other Metro and Light Metro products!

I am disturbed that Translink’s old SkyTrain ruse is still so effective, but without any investigative reporting by the mainstream media and so many politicians who want to jump on the subway band wagon the decision to build a subway really does not surprise me.

According to the Toronto Transit Commission (TTC), the North American standard for building a subway is a transit route or portion of a transit route that has customer flows in excess of 15,000 persons per hour per direction.

Simple and straight forward.

Calculating the maximum traffic flow on Broadway, using TransLink’s timetabled bus schedule, found the maximum capacity TransLink offered on Broadway was under 4,000 pphpd. Thus customer flows would be about the same.

In no way is there the customer flows on Broadway to justify a subway.

Yes, one can build a subway, but one must be prepared to pay high subsidies to keep the subway operating.

But, TransLink will already be paying extra high subsidies for the subway because the route is heavily used by U-Pass holders, which means, TransLink’s most expensive transit route will be unable to generate much revenue.

This means the Broadway subway must find additional revenue sources.

The TTC estimates that a new 6.5 km subway will add over $40 million in additional operating costs, thus it is safe to assume that the Broadway subway, just to Arbutus will increase TransLink’s operating subsidy by at least $40 million a year.

Combine the operating subsidies needed for the subway, plus the operating costs, the cost to the taxpayer will be in excess of $100 million annually!

This is no surprise as the annual operating subsidy for the original Expo line to New Westminster was estimated by the GVRD at $157 million annually!



From the Cost of Transporting people ….. GVRD 1992.

Has anyone ever thought about the long term financing for the subway?

The following is from a 2012 email from Wolfgang Keller, a German Transportation Engineer, should give pause to reflect that subways do have an expensive down size.

Over here in Germany where they had this tunnel-building mania from the 60s to the early 90s, at least they’ve stopped now. Simply because the municipalities ran into the fact that while building those tunnels is cheap (for them, not for the taxpayer), since 90% of the cost is financed with state and federal subsidies, they cannot finance maintenance of the fully grade-separated lines at all, so the expensive infrastructure they have built since the early 60′s is slowly rotting into a state of near-inoperability.

Has anyone looked at the long term finances of this subway?

TransLink planning veterans Tamim Raad and Brian Mills were fired because they asked those same questions and didn’t like the answer. They did not support the subway and were fired.

Now, let’s continue with TransLink’s pro SkyTrain biases.

American Transportation Engineer, Gerald Fox, was asked in 2008, by a Victoria group wanting streetcars in Victoria to look at the business case for the Evergreen Line.

His comments on the Evergreen Line’s business case was telling telling.



“The Evergreen Line Report made me curious as to how TransLink could justify continuing to expand SkyTrain, when the rest of the world is building LRT. So I went back and read the alleged Business Case (BC) report in a little more detail. I found several instances where the analysis had made assumptions that were inaccurate, or had been manipulated to make the case for SkyTrain. If the underlying assumptions are inaccurate, the conclusions may be so too.

Fox concluded:

It is interesting how TransLink has used this cunning method of manipulating analysis to justify SkyTrain in corridor after corridor, and has thus succeeded in keeping its proprietary rail system expanding. In the US, all new transit projects that seek federal support are now subjected to scrutiny by a panel of transit peers, selected and monitored by the federal government, to ensure that projects are analyzed honestly, and the taxpayers interests are protected. No SkyTrain project has ever passed this scrutiny in the US.

The report by McElhanney Consulting Services Ltd is badly flawed from the start, just as the Evergreen Line’s business case was. The consultants apparently have no background light rail or light metro and make many fundamental errors.

From the very beginning the study is biased against light rail and treats light rail as TransLink did in Surrey, planning LRT as a poor man’s SkyTrain.

I have found the Summary of Rapid Transit Technology Alternative Evaluation had too many instances where the analysis had made assumptions that were inaccurate, or had been manipulated to make the case for SkyTrain. Thus, if the underlying assumptions are inaccurate, the conclusions will be too.”

The study gives LRT a practical capacity of 6,120 persons, at the same time ignoring the fact that modern LRT has a practical capacity in excess of 20,000 pphpd, well known since the 1980′s

An extreme example is Karlsruhe Germany. The huge success of its regional tramtrain system, saw the main tram (streetcar) route through the city seeing a peak hour service of 40 second headway’s with coupled sets of trams and tramtrains giving a hourly capacity of in excess of 35,000 pphpd!



The “gelbe Wand” or yellow wall (referring to the yellow trams) on Kaiserstrasse in Karlsruhe, Germany.



Karlsruhe is now building a subway for that portion of route!

Before Toronto built its first subway, the Bloor-Danforth route saw coupled sets of PCC cars operating in peak hours, offering an hourly capacity of 12,000 pphpd!



In the late 1940′s and early 1950′s, the Bloor Danforth  streetcar line in Toronto saw
coupled sets of PCC cars operating in peak hours obtaining a capacity of 12,000 pphpd!



To say that a modern LRT line has less capacity than  an old streetcar line’s capacity, seventy years ago is more than a farce, it is deliberately dishonest!

Another questionable statistic is reliability as there has been no study offered to back up the claims that SkyTrain is unreliable.

Most if not all LRT lines operate to a strict schedule, no so for SkyTrain as there is no strict schedule at all, only a train every few minutes.

Any claim that is based on the reliability figures given should be immediately discounted.

The numbers given for light rail in the study are not just unreliable, they are deliberately skewed to favour SkyTrain. Thus the study is based on dishonest statistics and is useless as a planning document.

It is another glaring example of TransLink using their cunning method of manipulating analysis to justify SkyTrain in corridor after corridor, and has thus succeeded in keeping its proprietary rail system expanding.

Just as a reminder only seven of the proprietary SkyTrain systems have been built since the late 1970′s; only three are seriously used for urban transit; two are mired in court cases and investigations; one will soon be torn down as it is fast becoming “life expired”.

Not one SkyTrain built has ever been allowed to compete directly against light rail and this study by McElhanney Consulting Services Ltd. Is to ensure LRT does not compete against SkyTrain for transit on Broadway or in Metro Vancouver.

Thus the McElhanney Study is a political document masquerading as a technical document.

Addendum:

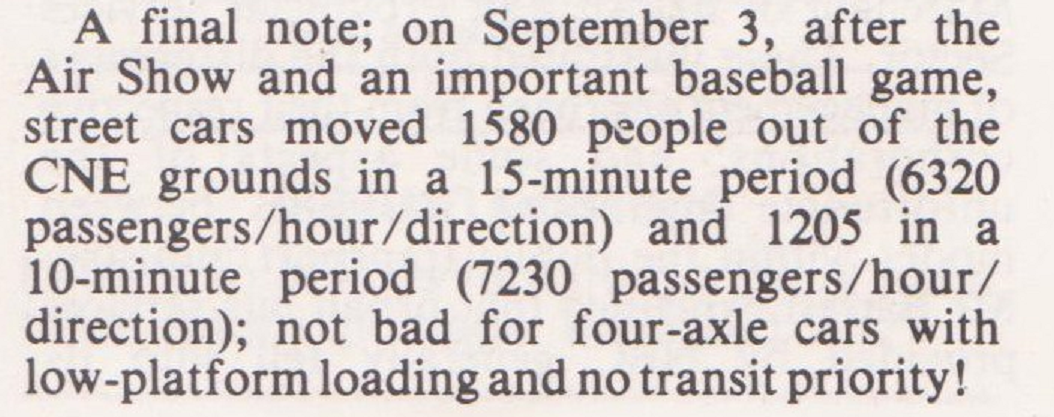

The following excerpt is from the December 1983 edition of Modern Tramway’s article The direction of TTC Planning in the 1980′s.





Clearly, the elderly Toronto trams were able to move more people in 1983, than what McElhanney Consulting Services Ltd.would have us believe what a modern articulated tram can move in 2019.
I think someone should demand their money back!
